Irregular Work Schedules: Understand scheduled and required time

Modified on Thu, 9 Apr at 5:14 PM

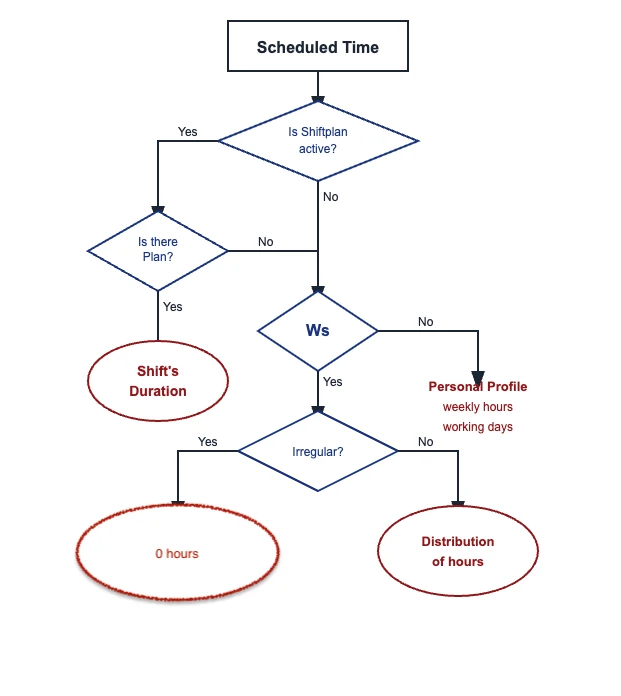

1. How Scheduled Time is defined


The system determines your employees' scheduled time using this priority order:

  1. Shift Plan (highest priority)
  2. Work Schedule:
  3. Personal Profile: contracted hours and contracted work days in the work section


The system always uses the first available source.


2. What you see per day

Each day shows your employees' scheduled time:


Situation
 What you see
⚖️ Regular schedule
Hours from your Work Schedule
  Irregular schedule
Hours from your Shift Plan
⛱️ Holiday / Time off
0h 0min
❌ No shift planned
0h 0min




Important: If no published shift has been scheduled for that day, the system will always show 0h 0min.



3.  Key Terminology distinction

  • Scheduled time =The hours your employee is scheduled to work (according to Shiftplan or Work Schedule)
  • Required time = The contracted hours you’re expected to work that week. Equivalent to contracted hours minus time-off and public holidays

4. Special case: No Shift Plan active

If:


1. You have an irregular work schedule, and

2. Shift Planning is not active


→ Your scheduled time will always be 0h 0min


5. Required time for irregular schedules

For irregular schedules, the system also calculates required time (the hours you are expected to work).


6. When required time is applied

If your scheduled time is lower than your weekly required hours, the system distributes your required hours across the week. For example, this is the case for on-duty employees with variable working hours.


7. How required time is calculated


Calculation: Weekly required hours ÷ Minimum working days = Daily required hours


Example: 32 hours per week ÷ 4 working days = Daily 8 hours required


8. Distribution logic

Option 1. If daily hours ≤ legal daily limit → distribute evenly


Example:

SettingValue
Weekly required hours32h
Minimum working days4
Legal daily limit8h


Calculation: 32 ÷ 4 = 8h

Result: 8h assigned to the first 4 working days

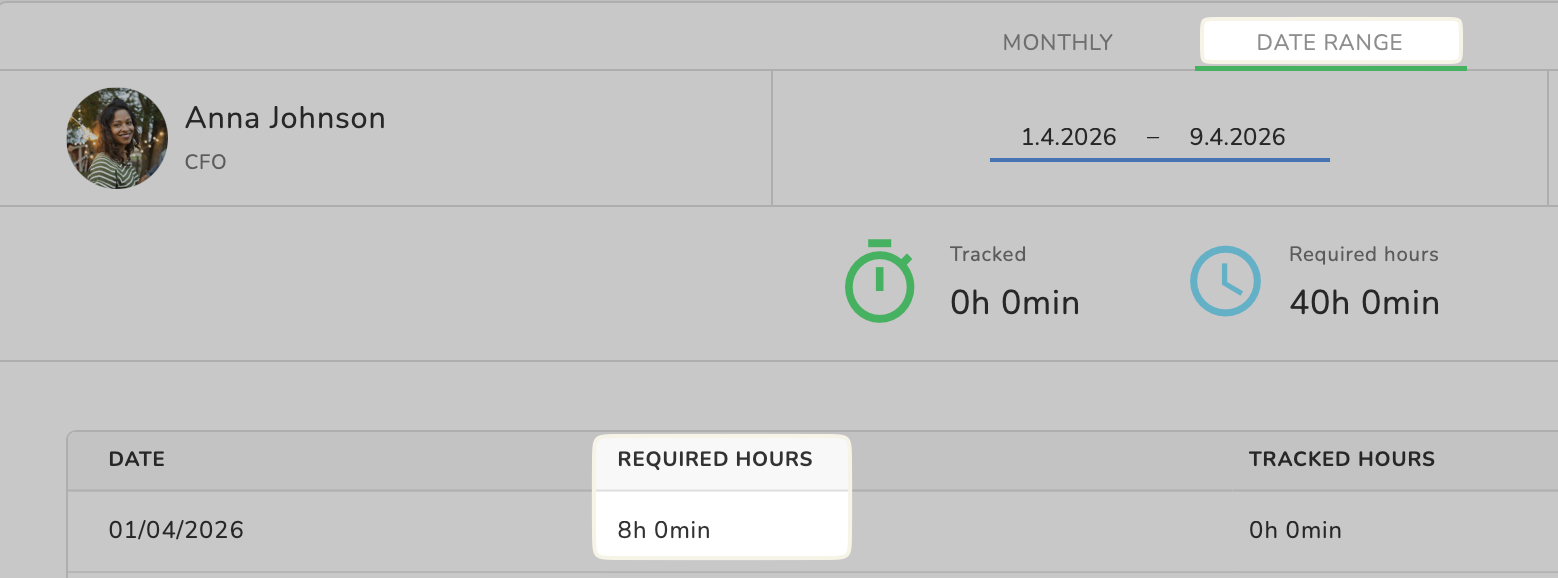

Important: You will not see this distribution of target hours in your employees' monthly view under the Employee profile > Attendance for individual days as planned hours. You can see it in the Date range view.


This calculation happens in the background and becomes relevant when the employee requests time off. Read more here about the time off policies for irregular work schedules.



Option 2. If daily hours > legal daily limit → cap at legal limit and spread across more days


Example:

SettingValue
Weekly required hours32h
Minimum working days3
Legal daily limit8h



Calculation: 32 ÷ 3 = 10,67 h

Result: Exceeds the daily limit by far, you need to distribute the remaining hours across an additional working day.




Key takeaway for you and your employees:

  • The system will never assign more than the legal daily limit per day.
  • Weekly hours are spread across the minimum working days first, then extra hours if needed.

9. Quick summary

  • Scheduled time comes from Shift Plan → Work Schedule → Employee Profile
  • If nothing is scheduled → 0h 0min
  • Required time helps fill gaps for irregular schedules
